Hulhumeedhoo – Hithadhoo Bridge

Hulhumeedhoo – Hithadhoo Bridge Project

Addu Atoll, Maldives

This timeline is compiled in collaboration with Project Thimaaveshi, Addu City

Basic Facts

Policy Origins & Background

  • idea first floated as an election pledge by President Maumoon Abdul Gayyoom in 2008
  • repeated by President Yameen Abdul Gayyoom while running for re-election in 2018, allegedly inspired by a child’s drawing
  • repeated by presidential candidate Mohamed Muizzu in the run up to the 2023 presidential elections

Project Details

  • length of the proposed bridge is 13-15 miles
  • estimated cost of the proposed bridge is unknown
  • MVR 30 million budgeted for a project survey in the 2024 State budget
  • the survey funds contradict alleged GoM claims that the survey will be conducted ‘free of charge’!
  • lack of transparency and public information disclosure notable in this project (like many others)
Hulhumeedhoo – Hithadhoo Bridge Project
13 Sept 2018
PRESIDENTIAL PLEDGE (2.0)

President Yameen Abdul Gayyoom pledged to link Hulhumeedhoo and Gan (Addu) during an election rally in Hulhumeedhoo. A news report said he was asked for this by a child from Addu using a drawing, which according to him, showed this is feasible.

ހިތަދު އާއި މީދޫ ވެސް ބްރިޖަކުން ގުޅާލާނަން: ރައީސް ޔާމީން

https://mihaaru.com/news/42277

07 Feb 2020
ADDU CITY COUNCIL ‘TAKEOVER’

Addu City Mayor is reported to have said that Addu City Council will present the GoM with the drawings of the Hulhumeedhoo-Hithadhoo bridge.

Addu City Council has not done this to date [as of March 2025]

– އާމްދަނީގެ ހިއްސާ ލިބޭ ނަމަ ހުޅުމީދުއާ، ހިތަދޫ ގުޅައިލެވުނީސް: ނިޒާރު

https://mihaaru.com/news/68909

21 Aug 2023
PRESIDENTIAL PLEDGE (3.0)

Mohamed Muizzu announces he will build a bridge between Hulhumeedhoo and Hithadhoo during an election rally in Addu Hithadhoo.

– ބްރިޖް އެޅުންތަނާއި އަޅަން އުޅެ ނޭޅުނުތަން ރައްޔިތުންނަށް ފެނިއްޖެ: މުއިއްޒު

https://sun.mv/181112

01 Nov 2023
BUDGET FOR SURVEY

MVR 30 million budgeted in the 2024 State Budget, to conduct a survey to build the Hulhumeedhoo-Hithadhoo bridge

https://atolltimes.mv/post/business/6209

23 Jan 2024
‘NOT JUST EMPTY TALK’
At the Male’ Mayor oath-taking ceremony President Mohamed Muizzu declares that the Hulhumeedhoo-Hithadhoo bridge is ‘not just empty talk’

https://edition.mv/features/31209

06 - 07 Feb 2024

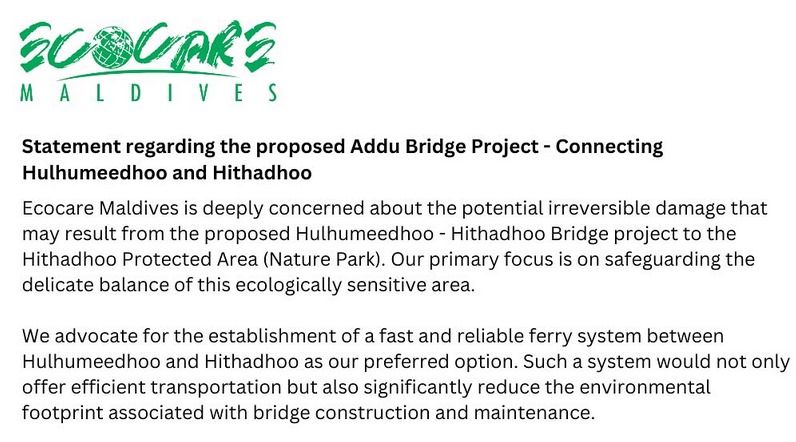

ECOCARE RAISES ALARM

Environmental NGO Ecocare Maldives issues a statement raising concerns about the proposed Hulhumeedhoo-Hithadhoo bridge project

– އައްޑޫ ބްރިޖުގެ ސަބަބުން ނޭޗާ ޕާކަށް ގެއްލުންވާނެތީ އިކޯކެއާގެ ކަންބޮޑުވުން

https://mihaaru.com/news/130783

Addu Bridge Risks Environmental Damage, Says Ecocare

https://edition.mv/news/31574

19 Feb 2024
ARAB CONTRACTORS

[photo: Mihaaru]

– News reports that the GoM had signed a contract with ‘The Arab Contractors – Osman Ahmed Osman & Co’

– ހިތަދޫ-ހުޅުމީދޫ ގުޅުވާލާ ރާއްޖޭގެ އެންމެ ބޮޑު ބްރިޖް މަޝްރޫއުގައި ސޮއިކޮށްފި

https://mihaaru.com/news/131226

– Addu City Mayor Ali Nizar reported to have said that the most capable person to implement the bridge that would change Addu is President Muizzu

– The report said the GoM signed the contract with ‘The Arab Contractors – Osman Ahmed Osman & Co’ who will be producing the Preliminary Design and Survey, free of charge.

[this raises questions about the budgeted MVR 30m for a survey, and what designs and surveys are being done by the contractor free of charge]

– އައްޑޫ ބަދަލުކޮށްލާނެ ބްރިޖު އެޅޭނީ ރައީސް މުއިއްޒަށް: ނިޒާރު

https://mihaaru.com/news/131230

10 Mar 2024
SPEEDY SURVEY COMPLETED

– News reports said that according to the Ministry of Construction & Infrastructure, the first survey of the Hulhumeedhoo-Hithadhoo bridge had been completed

– report said that the bridge survey began on Wednesday (6 March 2024), indicating the survey took 3-4 days)

ހިތަދޫހުޅުދޫމީދޫ ބްރިޖު މަޝްރޫއު: ފުރަތަމަ ސާވޭތައް ނިންމާލައިފި

https://sun.mv/189676

02 Jun - 15 Aug 2024 RTI Submission
PUBLIC INTEREST RTI

– a right to information (RTI) request was submitted to the Ministry of Construction & Infrastructure by a Hithadhoo resident, requesting for the following information about the Hulhumeedhoo-Hithadhoo bridge project:

a) summary of the technical proposal
b) sketches and drawings that have been completed
c) data from the mathematical survey
d) documentation about the project scope

– on 10 July 2024, the Ministry of Construction & Infrastructure replied to the RTI, stating the following :

– the MoU between the ministry and Arab Contractors to undertake the Hulhumeedhoo-Hithadhoo bridge project includes a non-disclosure clause

– as such, none of the requested information can be shared with the applicant as per section 22(b) of the RTI Act

– on appealing the ministry’s response to the Information Commissioner’s Officer (ICOM), a closed hearing between the ministry and ICOM was held on 24 July 2024 to review the MoU signed by the ministry and Arab Contractors

– on 6 August 2024, an open hearing was held, where the following decision was made by ICOM :

– as the technical proposal of the Hulhumeedhoo-Hithadhoo bridge project is being produced in phases, the ministry is to share the relevant information with the applicant on that basis within 5 working days

– it is clear from the clauses of the agreement that the requested information about the project drawings and mathematical survey are deemed to be the contractor’s ‘intellectual property’, hence may not be shared as per section 22(b) of the RTI Act

– following ICOMs decision, the ministry responded to the applicant on 15 August 2024, stating that:

– as the technical proposal for the Hulhumeedhoo-Hithadhoo bridge project is not completed, it is not possible to share a summary of the completed proposal, as requested

– that all information held by the ministry relevant to the project scoping had been shared with the applicant

07 Jun 2024
TECHNICAL DOCUMENTS DONE

– News report said that at a press conference about the work of the ministry over the first 6 months of 2024, the Construction minister Dr Abdullah Muththalib said that the mathematical survey and drawings of the Hulhumeedhoo-Hithadhoo bridge had been completed

– the Minister also disclosed that the feasibility study and design of the project was contracted to Arab Contractors under an MoU.

– that the contractor had now submitted the Summary of Technical Proposal to the ministry

– that the next stage is to arrange project financing, which has already been discussed with the contractor

ހިތަދޫ ހުޅުމީދޫ ބްރިޖްގެ ކުރެހުން ނިމިއްޖެ

https://javiyani.mv/post/news/7713

15 Jul 2024
CONTRACTOR FINDING FINANCE

– News report said that the Construction minister Dr Abdullah Muththalib responding to a question by an MP at the Peoples Majlis said that the project contractor is currently working to arrange project financing for the Hulhumeedhoo-Hithadhoo bridge project

– the report said that according to the minister, the GoM is currently evaluating the financing proposals submitted by the contractor

– the minister said that as per the agreement with the contractor, the company must arrange for the finance but the loan will be taken by GoM

އައްޑޫ ބްރިޖު މަޝްރޫއު: މިހާރު ކުރިޔަށް ދަނީ ފައިސާ ހަމަޖެއްސުމުގެ މަސައްކަތް

https://mihaaru.com/news/135670

06 Feb 2025
ANOTHER SURVEY TENDER ?

– In the annual Presidential Address at the opening of the parliament in Feb 2025, President Muizzu said :

“This month, the Government will open a tender to select a party to conduct detailed surveys and engineering designs to expedite the Addu Bridge project and carry out necessary technical work.”

https://presidency.gov.mv/Press/Article/33095

– the president’s speech appears to be inconsistent with what the minister for construction is reported to have said in the press conference of 7 June 2024 and later at the Majlis on 15 July 2024.

02 Mar 2025
EOI ISSUED - MORE SURVEYS

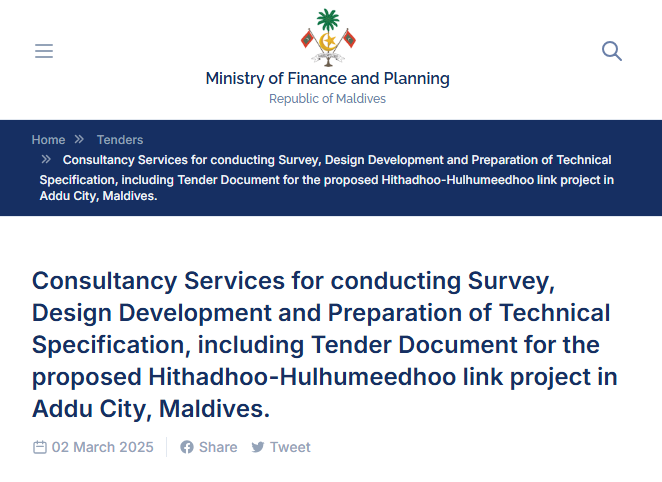

– News report that the Ministry of Finance had announced for expression of interest from a party to provide expert advice for the Hulhumeedhoo-Hithadhoo bridge project.

– the ministry’s call for EOI was seeking a company to produce the survey, designs, tender documents and technical specifications for the project

– the deadline for EOIs is 24 March 2025

އައްޑޫ ބްރިޖުގެ މަސައްކަތަށް ލަފާދޭނެ ބަޔަކު ހޯދަނީ

https://mihaaru.com/news/143313

– According to the EOI issued by the Ministry of Finance, under point 3 entitled ‘Scope of Services’, the Government of Maldives: “now seeks a consultancy firm for development of the detailed employer’s requirement, survey, technical documentation and bidding documents for the engagement of a Design and Build Contractor to construct the 3 bridges, other coastal structures and link road (hereinafter collectively to be referred as the “Project”).”

 [There is no information as to what these “3 bridges” are or the multiple additional infrastructure projects included in this EOI]



21 Mar 2025
BRIDGE MISSING IN DEV. PLANS

– News report that the Hulhumeedhoo-Hithadhoo bridge project was not included in the key infrastructure projects announced by the president’s decree that was amended and re-released today

https://www.addulive.com/397158

03 May 2025
STILL A PRESIDENTIAL PLEDGE!

– News report that the Hulhumeedhoo Hithadhoo bridge remains a “presidential pledge”
“Govt begins proposal evaluation for Hithadhoo-Hulhumeedhoo bridge”

Atoll Times – https://atolltimes.mv/post/news/12189

12 May 2025
MORE SURVEY DESIGNS & EVALUATIONS

– Answering a question by Hithadhoo MP Ahmed Azaan about the Hulhumeedhoo-Hithadhoo bridge, at the People’s Majlis meeting held on 12 May 2025, the Minister of Construction, Housing and Infrastructure Abdullah Muthalib said that the ministry is working on survey designs and project scoping to evaluate the estimated cost of the approximately 14km bridge which includes multiple causeways.

Minutes of the 29th meeting of the first session of the Peoples Majlis in 2025, held on 12 May 2025

Available on pg.26-27 at (Dhivehi PDF): https://majlis.gov.mv/storage/sessions/minutes/tYSzaxy2bS8E2FD9PxT8ExcONUxa0GLEvrNl7otU.pdf

05 Aug 2025
WHAT THE PEOPLE SAID

“For others – particularly Hulhumeedhoo residents –
the most pressing concern was never physical access
to the connected islands.
Rather than bridging over to services elsewhere,
they called for renewed focus on building up
what was missing locally:
tertiary education, emergency and maternal healthcare,
and digital infrastructure
that could reduce the need for travel altogether.
In this light, connectivity – the bridge –
was not imagined solely in a material sense,
but through the lens of self-sufficiency and equity.

Project Thimaaveshi & Transparency Maldives,
‘Development Through an Environmental Lens:
A Study on Perceptions and Attitudes Towards
Urban Development in Addu City, August 2025:176

– Addu based youth-for-youth NGO Project Thimaaveshi in collaboration with Transparency Maldives published a report focussing on ‘development’ in Addu. The report explores multiple ‘development’ projects in Addu historically and today, through an environmental lens.

Presenting its findings from the communities about the Hulhumeedhoo-Hithadhoo bridge, the report observed that what needed bridging for the local community is the prevailing inequity divide, as opposed to a hard engineered structure.
